AEP to build $4B, 702 MW of fuel-cell data center power for Google

On 14 October AEP said it will invest about $4 billion in 702 MW of Bloom fuel cells near Cheyenne, selling the power to Google for 20 years. AEP bought the cells in January, before the buyer was named. Full power is due by end-2028.

Share
Bloom gets paid first. Google's name came last. A gas-fired power plant lit at night under a navy sky. Illustrative photo, not the Cheyenne site.
BLOOM GETS PAID FIRST. Illustrative photo of a gas-fired power plant at night (Ocotillo, Arizona; Alan Stark, CC BY-SA 2.0, recoloured), not the Cheyenne site.

WIRE · HYPERSCALERS · US · Data as at 14 Oct 2026

Google now looks like the customer AEP left unnamed in January. On 14 October 2026 American Electric Power said it plans to invest about $4 billion in a 702 MW fuel cell plant near Cheyenne, Wyoming, and sell its power to Google under a 20-year power purchase agreement. The cells come from Bloom Energy. Back on 4 January, AEP had agreed, unconditionally, to buy fuel cells for a Cheyenne plant for about $2.65 billion, with the buyer described only as a "high investment grade" customer. So the equipment maker was signed up more than nine months before the buyer's name came out. On the Hyperscalers layer, this is Google's second power supplier for the same planned campus in two weeks.

What happened

14 October 2026

AEP plans about $4 billion for a 702 MW fuel cell plant near Cheyenne, with Google buying the power for 20 years

The plant company, Cheyenne Fuel Cell, is about 92% AEP and nearly 8% funds advised by Basalt Infrastructure Partners

The clock

Construction starts in 2026 and the plant is due to be fully running by the end of 2028

Bloom's cells make power from natural gas without burning it. Carbon capture is planned, not built

The January filing

On 4 January AEP signed an unconditional purchase of fuel cells for a Cheyenne plant, for about $2.65 billion

It came with a 20-year deal to sell all the output to an unnamed customer. If that deal's conditions failed, AEP would be paid back for all its capital and costs

The other supplier

Black Hills' Google agreements, in force from 30 September: $1.8 billion for 564 MW of new gas plants, service from late 2027

Black Hills says the campus will be served by 2.7 GW of resources in all, ramping to peak load in 2030, on terms that run to 2048

Why cash cares

Start with who gets paid first. Bloom does. AEP bought its cells in January without conditions, before the customer's name or the full project cost were public. AEP's release did not tie the two announcements together in so many words, but they describe the same thing: a fuel cell plant near Cheyenne with 20 years of output sold to one large buyer. If the $2.65 billion of cells sits inside the $4 billion, which AEP has not broken down, about two-thirds of the project's money goes to the cell maker. That leaves about $1.35 billion for everything else on the site.

AEP is paid next, on a slower clock. Under a power purchase agreement, the seller is normally paid for the power it delivers, so most of AEP's 20 years of revenue starts as the plant comes online, with full operation due by the end of 2028. If the 20 years start then, the contract runs to about 2048, the same year Black Hills' Google contracts end. AEP also took less risk than the size suggests: its January filing said it would be paid back for all capital and costs if the sale's conditions were not met.

Google pays for all of it. Black Hills said its agreements are set up so that Google bears every cost of serving the data center through 2048, and Google has already advanced $399 million for long-lead equipment there. Now Google is also the 20-year buyer of a second plant, from a utility whose 11 states do not include Wyoming. AEP said the deal shows it meeting energy needs "beyond our traditional service territory".

Here is our own arithmetic, not a company figure. $4 billion for 702 MW is about $5.7 million per MW. Black Hills' $1.8 billion for 564 MW of gas plants is about $3.2 million per MW. So, per MW, the fuel cells cost about 1.8 times the gas plants feeding the same campus. Together the two named builds come to 1,266 MW, about 47% of the 2.7 GW Black Hills says the campus will use. The cells were bought 283 days before Google's name appeared, and the end of 2028 is about 26.5 months away.

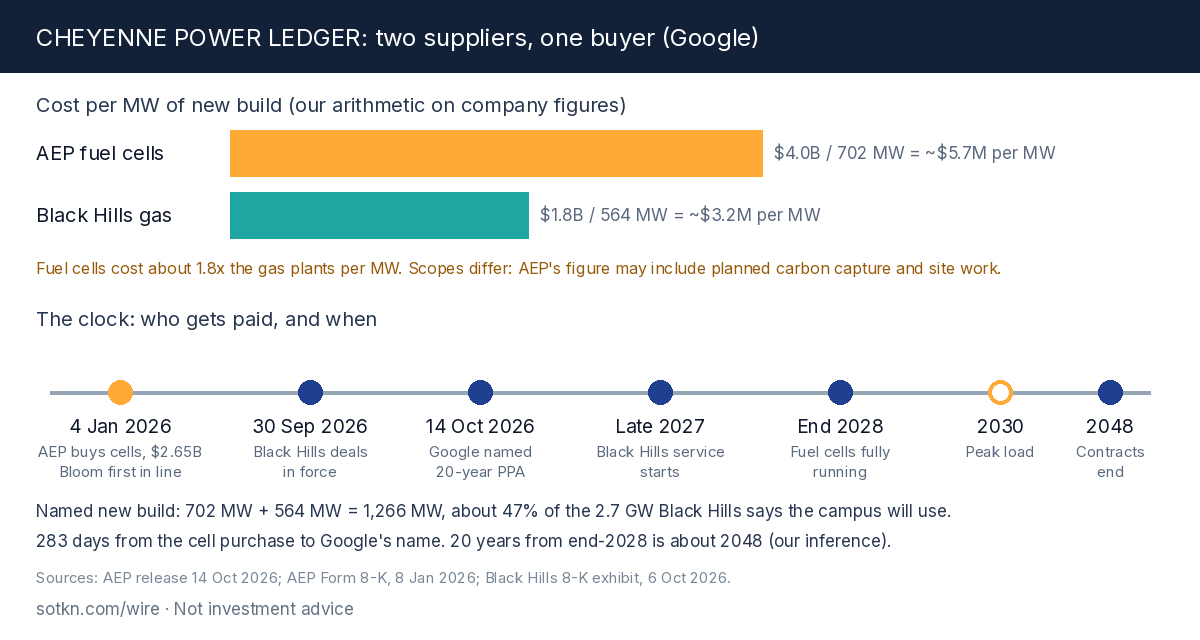

Cheyenne power ledger: who gets paid, and when, for Google's planned Wyoming data center

Figure: Cheyenne power ledger. Two suppliers, two price points, one buyer. The per-MW costs, the 1.8x, the 47% and the day counts are our arithmetic on AEP and Black Hills releases and filings.

The step that is still open

Getting power to the hall on Google's timetable. Black Hills plans to start serving the campus in late 2027 and ramp to peak load in 2030. The fuel cells are not fully running until the end of 2028. Until then the campus leans on Black Hills' gas plants, which it builds from 2027 to 2029, and on power bought from the market.

The rest of the 2.7 GW is the other open question. Black Hills says it will manage about 2.1 GW of other Wyoming suppliers' output through a private microgrid. Neither company said whether AEP's cells are part of that. If they are, about 1.4 GW of it is still unnamed. The wires are not all approved either: Black Hills filed for a South Cheyenne transmission expansion in September and plans a wider Wyoming transmission filing in the fourth quarter of 2026.

We have seen this pattern twice this month. On 6 October, Black Hills agreed to build $1.8B of gas power for Google in Wyoming. On 13 October, Oracle kept Bloom's fuel cells as the main power for Project Jupiter and offered El Paso Electric $10 million a year for backup. The hyperscaler pays to build its own power, and the equipment maker is the first to get paid.

The second-order read

Who gets paid. Bloom, first, on a cell order signed in January. Black Hills from 2027, when it starts earning a return on its build. AEP and the Basalt funds over 20 years, once power flows.

Who pays. Google, for both plants, on contracts that run to about 2048.

Who waits. AEP's revenue waits for the plant, due by the end of 2028. Google's hall waits for enough power to reach peak load in 2030.

Stuck step. Power to the hall. Two suppliers are named and paid for, and they cover less than half of the 2.7 GW the campus is planned around.

Three cautions

AEP did not break down the $4 billion or say whether the $2.65 billion cell order sits inside it. Our two-thirds share assumes it does.

The per-MW comparison mixes two technologies and two scopes. AEP's figure may include the planned carbon capture and site work, and both are nameplate MW, not power delivered.

Nobody published a price for the power, the size of Google's hall, or whether the fuel cells count toward Black Hills' 2.1 GW. The 2048 end date for AEP's contract is our inference from a 20-year term starting at full operation.

What to watch

  • Construction start: AEP says building begins in 2026, which leaves 78 days of the year from 14 October.
  • Bloom's next quarterly report: whether it shows the Cheyenne order and a delivery schedule.
  • Black Hills' Wyoming transmission filing: due in the fourth quarter of 2026.
  • First service to the campus: Black Hills' late-2027 date is the first test of the ramp.

Read: Hyperscalers, what Google does and AI Data Centers


Get the Wire. A free brief every day, here and in your inbox. Subscribe free →

Not investment advice. Do your own research. The two-thirds share, $1.35 billion, $5.7 million and $3.2 million per MW, 1.8x, 1,266 MW, 47%, 1.4 GW, 283-day, 26.5-month and 78-day figures are our arithmetic.
