Nvidia carries $56B of neocloud commitments as a shakeout looms

Industry executives expect only 7 to 10 neoclouds to survive, The Information reported on 18 October. Nvidia has already been paid for the chips; its filing shows $36 billion of cloud hours it may have to buy back and $20 billion of leases it must hand on.

Share
$56B on the hook if neoclouds fall. Nvidia's headquarters entrance and sign in Santa Clara, graded navy, with an amber glow on the Nvidia sign.
Base photo: NVIDIA headquarters, Santa Clara, 4 Aug 2018, by Coolcaesar via Wikimedia Commons (CC BY-SA 4.0), graded for Second Order.

WIRE · NEOCLOUDS · US · Data as at 19 Oct 2026

Industry executives expect only 7 to 10 of the hundreds of neoclouds now renting out AI chips to survive, The Information reported on 18 October 2026, and Nvidia is the company holding them up. Its own filing shows how much: $36 billion of promises to buy back cloud hours its partners can't sell, $20 billion of 15-year data center leases it signed on their behalf, and $3.5 billion of guarantees on their landlords' rent. On the neoclouds layer, Nvidia has already been paid for the chips. The risk it kept is whether anyone rents them.

What happened

18 October 2026 · The Information

Only 7 to 10 of hundreds of neoclouds are expected to survive a shakeout

Unnamed industry executives gave the estimate. The report says Nvidia supports the sector with easier credit terms, help finding sites and about $20 billion of data center leases, and that this support is also its exposure

26 August 2026 · Nvidia quarterly filing (quarter to 26 July)

$36 billion of AI cloud agreements, typically six years long

The AI clouds buy Nvidia systems and Nvidia commits to buy cloud service from them. The clouds can stop supplying Nvidia at any time and sell the same capacity to others at better rates. The commitment shrinks as outside customers use the capacity. Nvidia called it a new business model, introduced that quarter

26 August 2026 · Nvidia quarterly filing

$20 billion of data center leases signed for third parties, plus $3.5 billion of rent guarantees

The leases run about 15 years, start between fiscal 2028 and fiscal 2029 depending on construction, and Nvidia expects to hand them to someone else. The guarantees cover select AI clouds' land, power and shell leases if they default; the partners have put $712 million in escrow

18 October 2026 · Bloomberg, via Stocktwits

Investors push Nscale toward $16 billion to $19 billion, against the $30 billion it wants

The same weekend, after a week in which CoreWeave's 2032 bonds fell below 80 cents on the dollar


Why cash cares

Nvidia sells the GPUs first. Under the AI cloud agreements, the neocloud buys Nvidia systems, and Nvidia promises to rent back whatever capacity the neocloud can't place with paying customers. If outside demand is strong, the neocloud sells the hours elsewhere at a better price, Nvidia's commitment shrinks, and Nvidia may also get a share of that revenue. If demand is weak, Nvidia ends up as the customer.

That makes the $36 billion a bet on GPU rental prices, not a loan. Right now prices are going the right way for Nvidia. Nebius raised its listed H100 price from $3.85 to $4.50 an hour from 1 October, according to a review of public GPU price data published on 18 October. The test is a shakeout, when a failed neocloud's hours come back to Nvidia at the same moment survivors are cutting prices to win customers.

The leases are the slower part. Our arithmetic from the filing's own schedule: $17 billion of the $20 billion, or 85%, falls in fiscal 2032 and later. Those are long rent payments on buildings that aren't finished, and Nvidia says that if it can't hand them on in time, it may have to carry the lease costs itself.

Nvidia's neocloud backstops from its August 2026 filing: $36 billion of AI cloud agreements, $20 billion of data center leases for third parties and $3.5 billion of rent guarantees, set against The Information's estimate of 7 to 10 surviving neoclouds

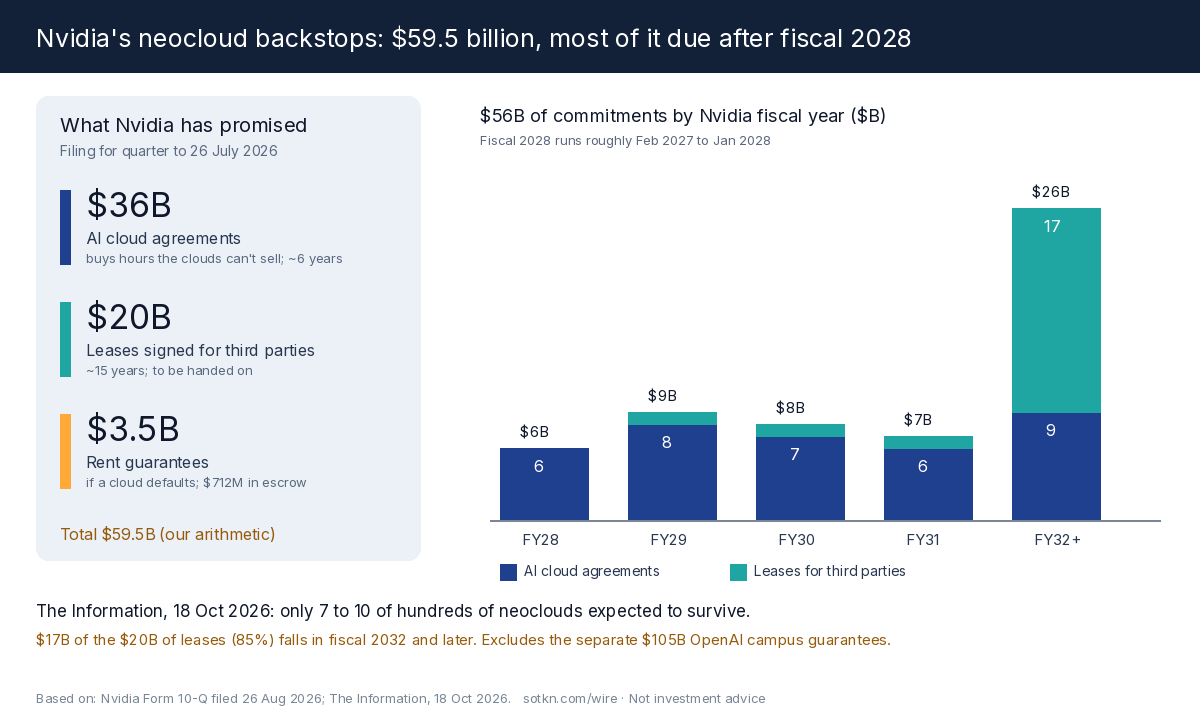

Figure: Nvidia's $59.5 billion of neocloud backstops, by when they come due. Totals from Nvidia's filing for the quarter to 26 July 2026. The combined total is our arithmetic.

The second-order read

Who gets paid. Nvidia, first and in cash, for the systems the clouds buy. The landlords on the $20 billion of leases, who have Nvidia's name on a 15-year contract instead of a young cloud's. Lenders to the neoclouds, whose borrowers have Nvidia as buyer of last resort. Sharon AI is one named partner: it reported a $4.9 billion, six-year compute deal with Nvidia for up to 40,000 GB300 GPUs on 6 August.

Who carries the risk. Nvidia, on hours that go unsold and on leases nobody takes over. The equity holders of the neoclouds that don't make the cut, because Nvidia's promise protects the use of the racks, not the companies.

Who waits. The third parties Nvidia needs to take over the leases, before construction finishes, between early 2027 and early 2029. The 7 to 10 survivors, who would be first in line for those halls.

Stuck step. Reselling compute. Chips, power and buildings can all be bought. What Nvidia now depends on is whether enough AI customers pay rent for the hours, at prices that keep its commitments shrinking.

Two cautions

The 7-to-10 estimate comes from unnamed executives, and the full report is behind a paywall. The Information's "about $20 billion of leases" matches the filing's figure for leases signed for third parties; the reports do not name the clouds behind the $36 billion.

Don't add the $6.3 billion CoreWeave order from September 2025 to these totals. That deal predates the new model, and the filing does not say whether it sits inside the $36 billion. The separate guarantees of up to $105 billion for an OpenAI campus in Ohio are also left out here, because that customer is a model maker, not a neocloud.

What to watch

  • Nvidia's next quarterly filing, for whether the $36 billion has shrunk (hours sold to others) or grown (more clouds signed), and whether any of the $20 billion of leases has been reassigned.
  • Nscale's IPO price, the first public test of what investors will pay for a neocloud after this month's sell-off.
  • GPU rental prices. If list prices keep rising, the AI clouds sell their hours elsewhere and Nvidia's exposure shrinks. A price cut by a large cloud would be the first warning.

Read: What is a neocloud?, GPU financing explained, and CoreWeave default swaps top 1,000 bp as Gartner sees neocloud shakeout


Get the Wire. A free brief every day, here and in your inbox. Subscribe free →

Not investment advice. Do your own research. The $59.5 billion and $56 billion totals, the 85% share of leases in fiscal 2032 and later, and the dating of fiscal years are our arithmetic from Nvidia's filing.

References

  1. The Information, "Neocloud Shakeout Looms, and Nvidia Has a Lot to Lose", 18 Oct 2026. The 7-to-10 survivor estimate and Nvidia's support for neoclouds.
  2. Nvidia, Form 10-Q for the quarter ended 26 July 2026, filed 26 Aug 2026. AI cloud agreements, leases for third parties, rent guarantees, escrow and the SB Energy guarantees.
  3. Stocktwits via Yahoo Finance, "CRWV, NBIS, IREN Bounce Overnight After Brutal Week", 19 Oct 2026. Summary of The Information and of Bloomberg's Nscale valuation report.
  4. SecondSource, "Is GPU compute tight? The answer is in contract length", 18 Oct 2026. Nebius list price change from 1 October.
  5. Sharon AI, second-quarter 2026 results, 6 Aug 2026. The $4.9 billion six-year Nvidia compute collaboration.
  6. CoreWeave, Form 8-K (Nvidia order form), 9 Sep 2025. The $6.3 billion unsold-capacity agreement through 13 Apr 2032.
