Lambda closes $1B investment-grade GPU loan

Lambda (1 Oct): $1.008B delayed-draw GPU loan at 6.78%, rated Baa1. The loan is closed; the cash waits for each cluster to switch on.

Share
$1B LOAN — Cash waits for switch-on. A dark AI data hall with one GPU rack lit amber as it is commissioned.

WIRE · NEOCLOUDS · GLOBAL · Data as at 1 Oct 2026

Lambda, the US GPU cloud, said on 1 October 2026 that it has closed a $1.008 billion loan to buy and build GPU clusters for two investment-grade customers. The money is real and the price is fixed at 6.78%. But the loan only pays out as each cluster is switched on, and it only gets paid back if those customers pay for the hours. On the neoclouds layer, a closed loan is ready money. It is not paid hours yet.

What happened

On 1 October 2026, Lambda (Lambda press release, 1 Oct 2026; also Business Wire carry, 1 Oct 2026) announced it had closed a $1.008 billion delayed-draw term loan. It was sold to insurance companies and other fixed-income investors. Lambda says the deal was oversubscribed and priced inside its target range. Those two claims are the company’s own.

The money will pay for GPU servers and the build-out behind three committed customer deployments with two investment-grade customers, spread across several data centres. The release calls those customers hyperscale buyers. It does not name them.

The key word is delayed draw. Lambda does not get $1.008 billion on day one. It draws money in steps, as each cluster reaches its commissioning milestone and enters service. The loan pays a 6.78% fixed rate every six months, runs to 30 May 2033, and pays down in full over its life. It is secured by the GPU servers it buys and by the customer contracts. Moody’s rated it Baa1 and Morningstar DBRS rated it A (low) — both investment grade.

This is Lambda’s second loan from institutional investors. The first closed on 27 August 2026.

Event

Lambda closes a $1.008B delayed-draw GPU term loan

Lambda press release (Business Wire), 1 Oct 2026

What it pays for

GPUs and build-out for 3 committed deployments

Same — two investment-grade offtakers, multiple data centres

How cash moves

Drawn in steps as clusters are commissioned

Same — money funds only as gear enters service

Price

6.78% fixed, paid every six months

Same — priced inside the target range

Term

Final maturity 30 May 2033, fully amortizing

Same

Ratings

Baa1 (Moody’s) · A (low) (Morningstar DBRS)

Same — ratings on the loan, not on the customers

Security

The GPU servers it funds plus the contracted cash flows

Same

Not disclosed

Customer names, each customer’s share, the draw schedule

Same — the release names none of these

So the order is simple. The loan is closed. The cash comes out only when clusters go live. And the lenders get paid only when the two customers pay for what runs on them.

Why cash cares

Most GPU money stories end at the headline number. This one shows the steps. A neocloud like Lambda rents GPU time to buyers who cannot or will not build their own clusters (see What Is a Neocloud?). To do that it has to buy the chips first. Who Finances GPU Clusters covers the usual answer: lenders put up the cash, and a customer contract pays them back.

Lambda’s release lays out three steps, and only the first one is done.

  1. Loan closed. Done on 1 October. Investors have agreed to lend up to $1.008 billion at 6.78%.
  2. Cash drawn. Not done. Money comes out as each cluster hits its commissioning milestone. If a hall is late, or power is late, or the servers are late, the draw waits.
  3. Hours paid. Not done. The two customers pay for the clusters once they run. That cash pays the coupon and pays down the loan through May 2033.

That middle step is the stuck step. A closed loan tells you lenders trust the contracts. It does not tell you when the GPUs go live. Ready is not paid.

Here is the size of the bill, as our own arithmetic. If the full $1.008 billion is drawn, 6.78% works out to about $68 million a year in interest alone, before any principal. Because the loan pays down in full by 2033, the yearly payments will be larger than that. Those payments only work if the customer hours keep coming in.

Loan bind — a closed loan is not drawn cash, and drawn cash is not paid hours

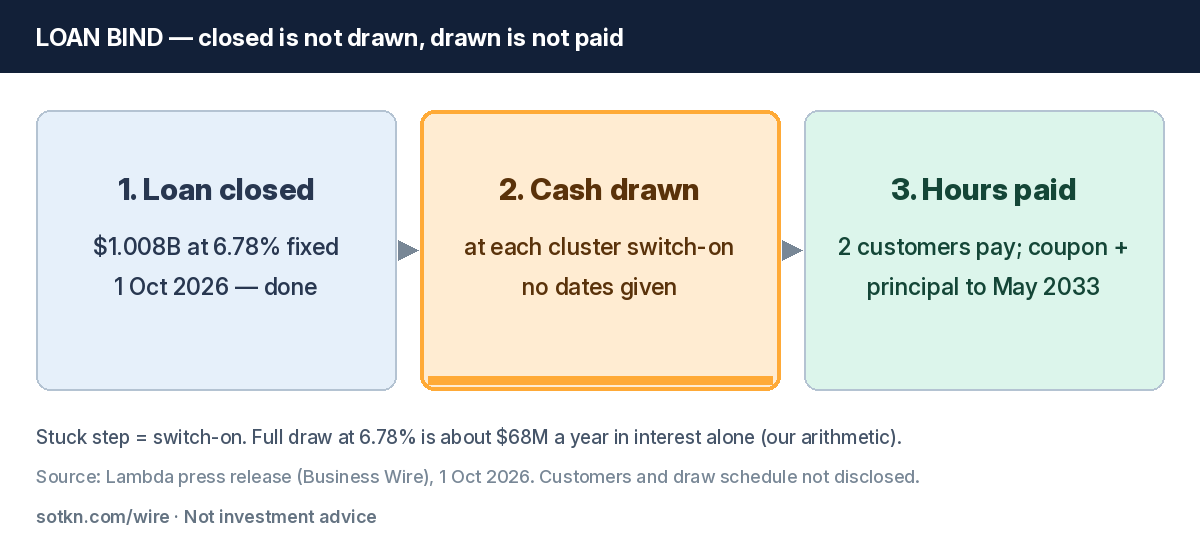

Figure — The loan bind. Loan closed (1 Oct) → cash drawn at each cluster switch-on → customers pay for hours, which pays the 6.78% coupon and the principal. Amber marks the stuck step: switch-on.

Compare this with yesterday’s Wire on Amazon’s $8B chip leaseback. Amazon is still in talks, with chips already installed. Lambda’s loan is closed, with clusters not yet live. Each deal is missing a different step.

The second-order read

Who Seat What this means
Lambda Borrower and GPU cloud Locks in a fixed 6.78% cost; keeps whatever the customers pay above the debt bill
Insurers and bond buyers Lenders Get the coupon and principal if the clusters go live and the customers pay
Two investment-grade customers Offtakers Their payments are what services the loan; names and shares not disclosed
GPU and server makers Sellers Get paid when Lambda draws the loan to buy hardware
Data-centre hosts Power and space Their power and space dates feed the commissioning milestones; not named in the release
J.P. Morgan Arranger Sole coordinating lead arranger and bookrunner

Who gets paid. First in line are the GPU and server sellers, because the draw buys their hardware. Next are the lenders, paid every six months from customer cash. Lambda earns the gap between what its two customers pay and what the loan costs.

Who waits. Lambda waits on commissioning. Until a cluster enters service, that slice of the loan is not drawn and those GPU hours are not billed. The lenders wait on the same thing. Anyone reading $1.008 billion as cash already spent, or as revenue, is also waiting.

By clock. Loan closed: 1 October 2026. Draws: at each commissioning milestone, with no dates given. Payments: every six months, fully paid down by 30 May 2033. The release does not say how fast the clusters go live, so we cannot say how fast the cash moves. That is the line to watch.

This matters past Lambda. Investment-grade GPU debt sold to insurers means GPU clusters can now borrow at fixed, long-dated rates, as long as a strong customer contract sits behind them. That works only while the customer pays for the hours. It is the same idea behind a take-or-pay GPU contract: the contract is only as strong as the buyer, and the hardware has to show up on time.

Two cautions

The $68 million a year is our own arithmetic for the full-draw case, interest only. The release gives no draw schedule, no repayment table, and no split between the two customers. Do not turn it into a yearly cash figure for Lambda.

The ratings are on the loan, not on the customers, and not on Lambda’s whole business. Two customers behind one loan is better than one, but the release does not show how much each one pays. The 27 August loan funded one customer’s deployment. We do not know if the customers overlap.

What would change the view

  • A dated go-live for any of the three deployments, or a statement that draws have started.
  • Customer names or a split of the contracted cash between the two buyers.
  • A delay in power, halls, or hardware that pushes commissioning milestones out.
  • A rating action on the loan, up or down, from Moody’s or Morningstar DBRS.

What to watch

  • Draw pace — any update from Lambda on how much of the $1.008 billion has been drawn.
  • More fixed-rate GPU loans — whether other neoclouds sell investment-grade GPU debt to insurers at similar rates.
  • Customer disclosure — if either buyer confirms the deal, the contract risk becomes easier to read.
  • Lambda’s next raise — it says it has raised about $1 billion in each major 2026 financing; the next one shows what lenders charge after this 6.78% print.

Read: Neoclouds, What Is a Neocloud?, Who Finances GPU Clusters, What Is a Take-or-Pay GPU Contract?, What Is GPU as a Service?, and GPU Cloud Providers.


Get the Wire. A free brief every day, here and in your inbox. Subscribe free →

Sources: Lambda press release, 1 Oct 2026 — $1.008B delayed-draw term loan; 6.78% fixed semi-annual; maturity 30 May 2033, fully amortizing; Baa1 Moody’s, A (low) Morningstar DBRS; three committed deployments, two investment-grade offtakers; draws tied to commissioning; secured by funded GPU servers and contracted cash flows; first facility closed 27 Aug 2026; Business Wire via Yahoo Finance, 1 Oct 2026 — same release; btw.media, 2 Oct 2026 — 27 Aug facility funded one investment-grade customer deployment; customer shares not disclosed. Interest figure is our arithmetic. Not investment advice.
