1,100 MW Signed: Who Gets Paid While Microsoft's Indiana Plants Still Wait
NiSource on 16 Oct signed Microsoft to about 1,100 MW from 2028. AGP and GenCo are paid; the only named plant is a 600 MW battery still on paper.
NiSource on 16 October signed Microsoft into a 20-year energy agreement for the northwest Indiana campus. About 1,100 MW joins the pool its generation arm runs for big data-centre customers, Microsoft pays for the generation and transmission it needs, and service starts in 2028. Who gets paid is AGP Group on the battery toll and GenCo on the pool. The stuck step is named generation: the only plant printed is a 600 MW battery that is not binding until 31 January 2027.
US PULSE · Data as at 19 Oct 2026 · Next update: after NiSource Q3 on 28 Oct or a named-plant filing
Affects: Hyperscalers · Speed-to-power · Power — Markets: US · Taiwan · Korea
Education only, not advice to buy or sell any security. Figures: NiSource release 16 Oct, Form 8-K filed 16 Oct (event 15 Oct), IURC Cause 46362 17 Jun, NERC ballot 15 Oct. Our own sums are labelled “our arithmetic”.
The numbers that matter this month
Pool add (Microsoft)
~1,100 MW
20-year term from 2028 · Microsoft funds generation and transmission
PrimaryNamed plant (8-K)
600 MW / 2,400 MWh
Atlas Storage 1 LLC · first phase expected by 1 Dec 2027
HeadlineToll payments (expected)
$2.2bn
~20.5 years · booked as a finance lease
Paid nowCustomer-savings claim
~$1.75bn
Was $1.4bn · up to $140 per customer a year
ClaimNERC large-load floor
50 MW at ≥100 kV
Final ballot 15 Oct · board then FERC
OverlayNamed generation
Still the bind
One battery, not yet binding. The rest of the 1,100 MW is unnamed.
Stuck stepStatus chips are Second Order’s read. Figures come from NiSource’s 16 Oct 2026 release, the Form 8-K filed 16 Oct and NERC’s 15 Oct ballot as reported.
Why does the US matter now?
Because the US is where AI halls buy watts before they buy wafers, and this week’s print shows a hyperscaler paying for a pool — not for a named plant.
The 15 October pulse, $4 billion for 702 MW, read AEP buying fuel cells for Google in Wyoming before the hall existed. Today is the Indiana version of the same clock, on a Microsoft cheque. A signed pool is not a turbine on a pad.
1 · Battery toll
Who: AGP Group / Atlas Storage 1 LLC
Paid: expected $2.2bn of storage payments over ~20.5 years if 31 Jan clears
2 · The pool operator
Who: NiSource Generation Company (GenCo) and NIPSCO wires
Paid: Microsoft funds generation and transmission; existing customers are the stated $1.75bn savings line

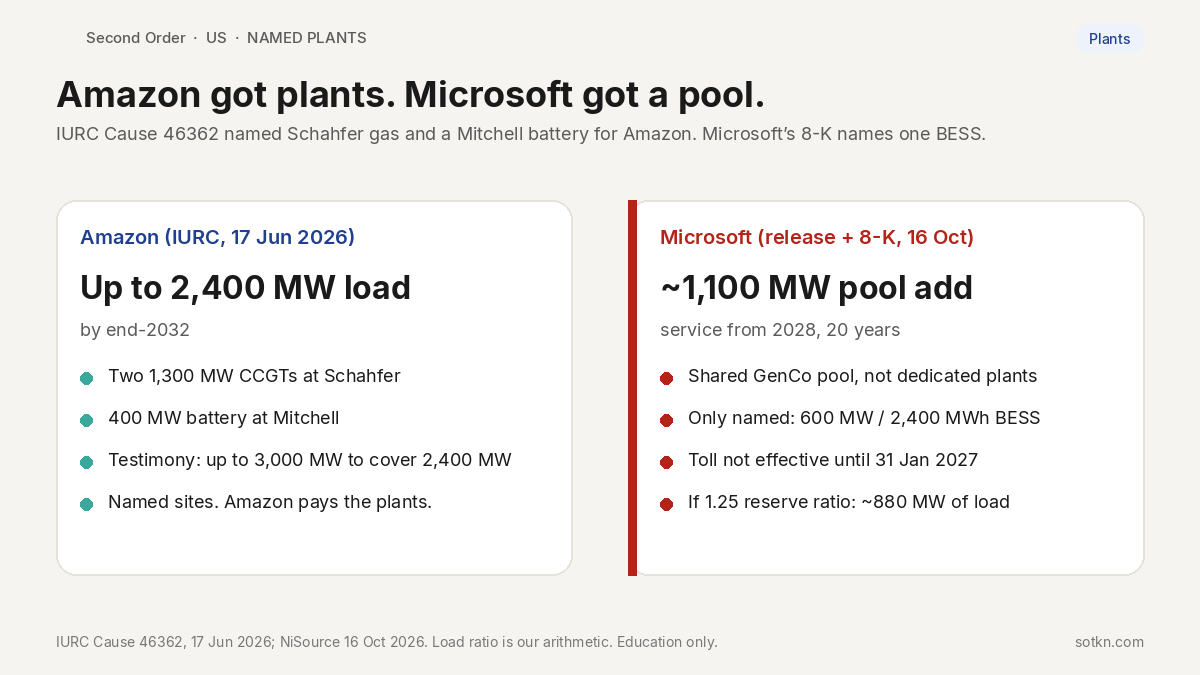

3 · Amazon’s named plants
Who: Two 1,300 MW CCGTs at Schahfer; 400 MW battery at Mitchell
Paid: Amazon, already, under IURC Cause 46362
4 · Named generation for Microsoft
Who: Not printed, except the battery
Paid: Not yet. A four-hour battery cannot carry a campus that runs all day
Labels: Paid first = the toll collects if the conditions clear. Paid on the pool = Microsoft funds the kit GenCo runs. Stuck step = the 1,100 MW is a pool add, not a plant list.

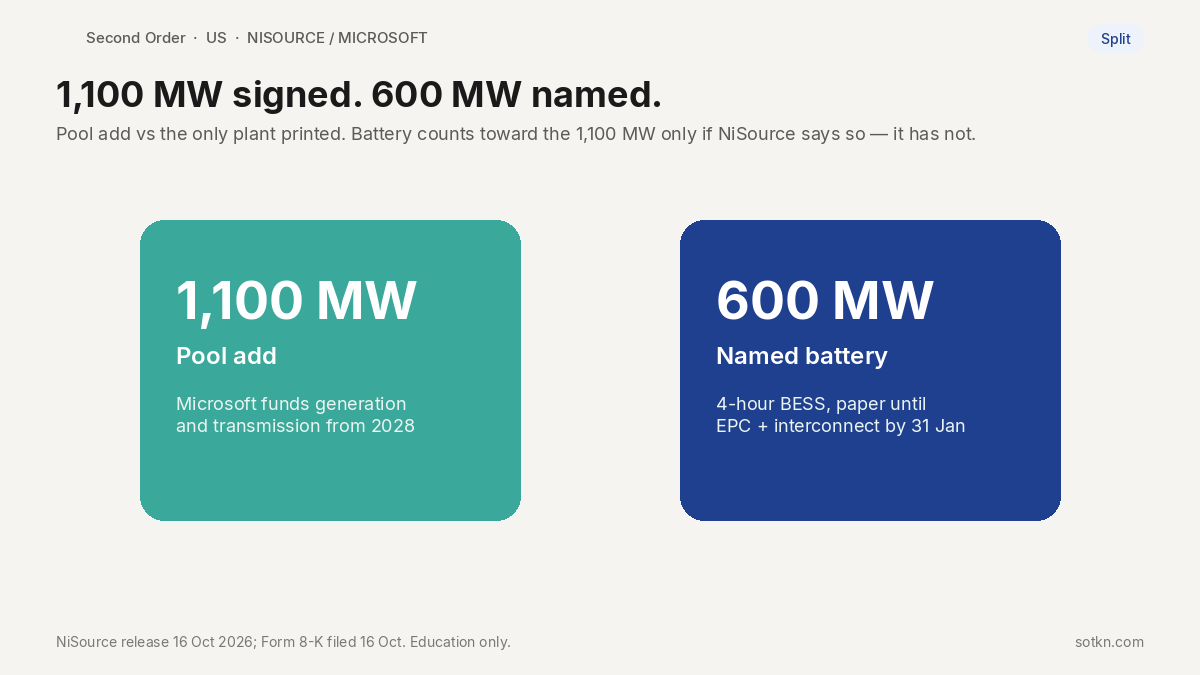

If you only remember one thing: 1,100 MW signed is a pool print, not a plant print. Microsoft is paying to join the machine Amazon already sits on. The machine still has unnamed turbines.
What changed on 15–16 October
Two NiSource papers and one reliability ballot landed inside 48 hours.
On 15 October, GenCo signed a Battery Storage System Tolling Agreement with Atlas Storage 1 LLC, an indirect subsidiary of AGP Capital Holdings Pte. Ltd. The Form 8-K, filed 16 October, is the hard print. AGP Group will develop, construct, own and operate a 600 MWAC / 2,400 MWh stand-alone battery on the MISO grid. GenCo supplies the electricity that charges it, tells it when to dispatch, and keeps the market revenue. The term is about twenty and a half years from first-phase commercial operation, expected by 1 December 2027. GenCo expects about $2.2 billion of storage payments, as a finance lease. The toll is not effective until AGP signs an EPC contract and a satisfactory interconnection agreement, both by 31 January 2027. GenCo holds an option to buy the project later.
On 16 October, NiSource announced a 20-year energy agreement with Microsoft for the previously announced northwest Indiana campus. Service is expected to begin in 2028. The GenCo-owned pool grows by about 1,100 MW. Microsoft fully funds all generation and transmission required to serve its load. Expected savings for existing NIPSCO electric customers rise from $1.4 billion to about $1.75 billion, or as much as $140 per customer a year. Inside Indiana Business places the campus in La Porte. More detail was promised for the third-quarter call.
The same 16 October release says the 600 MW battery “will be added to GenCo’s pool resource assets designed to serve multiple large-load customers.” It does not say the battery is Microsoft’s, and it does not say the 600 MW is inside the 1,100 MW. Treat that as open.
A day earlier, NERC stakeholders passed a final ballot on Project 2026-02 computational-load standards, Utility Dive reported on 15 October. The rules cover computational loads of 50 MW or more at 100 kV or above. They still need the NERC board and then FERC. ERCOT’s 15 October briefing put every standard above the 66.67% pass line, with CLO-001-1 at 81.58%. Microsoft’s 1,100 MW is 22 times the 50 MW floor (our arithmetic). The ballot does not switch a hall on. It is the overlay: a signed US pool of this size is now a reliability object, not only a customer contract.

Our math: labelled our arithmetic
NiSource already printed the dollars and the megawatts. What follows is division on those figures, labelled as ours.
- Battery duration. 2,400 MWh ÷ 600 MW = 4.0 hours (our arithmetic). A four-hour battery is a shifter, not a campus baseload.
- Named share, if the battery counts. 600 ÷ 1,100 = 0.545, or 54.5% (our arithmetic). NiSource has not said it counts. If it does, about 500 MW of the pool add is still unnamed. If it does not, the whole 1,100 MW is unnamed except as “pool”.
- Toll per year. $2.2 billion ÷ 20.5 years = $107.3 million a year (our arithmetic).
- Toll per kW-month. $107.3 million ÷ 12 ÷ 600,000 kW = about $14.90 per kW-month, before the adjustments the 8-K allows (our arithmetic). That is the price of a named four-hour resource, not the price of 1,100 MW of around-the-clock power.
- Days until the toll can die. 31 January 2027 minus 19 October 2026 is 104 days (our arithmetic).
- Implied Microsoft load, if Amazon’s reserve ratio held. IURC Cause 46362 records testimony that 3,000 MW of generating capacity is needed to serve Amazon’s anticipated 2,400 MW of load under MISO accreditation — a ratio of 1.25. 1,100 ÷ 1.25 = 880 MW of load (our arithmetic). Illustration only. NiSource has not given a Microsoft load figure.
- NERC multiple. 1,100 ÷ 50 = 22 (our arithmetic). This campus, at the printed pool add, is twenty-two times the computational-load floor that just passed ballot.
- Savings add. $1.75 billion − $1.4 billion = $350 million (our arithmetic). That is the Microsoft-shaped increment on a life-of-contract claim, not a cash cheque this quarter.

What this tells you: the only named plant is a four-hour battery that is still a pair of contracts, and even if it counts it covers just over half the pool add. The rest has to be gas, other plants or capacity bought in the market, and none of it is named. It does not tell you what a NiSource share is worth. We do not do price calls. The 28 October call is the next place a plant list can appear.

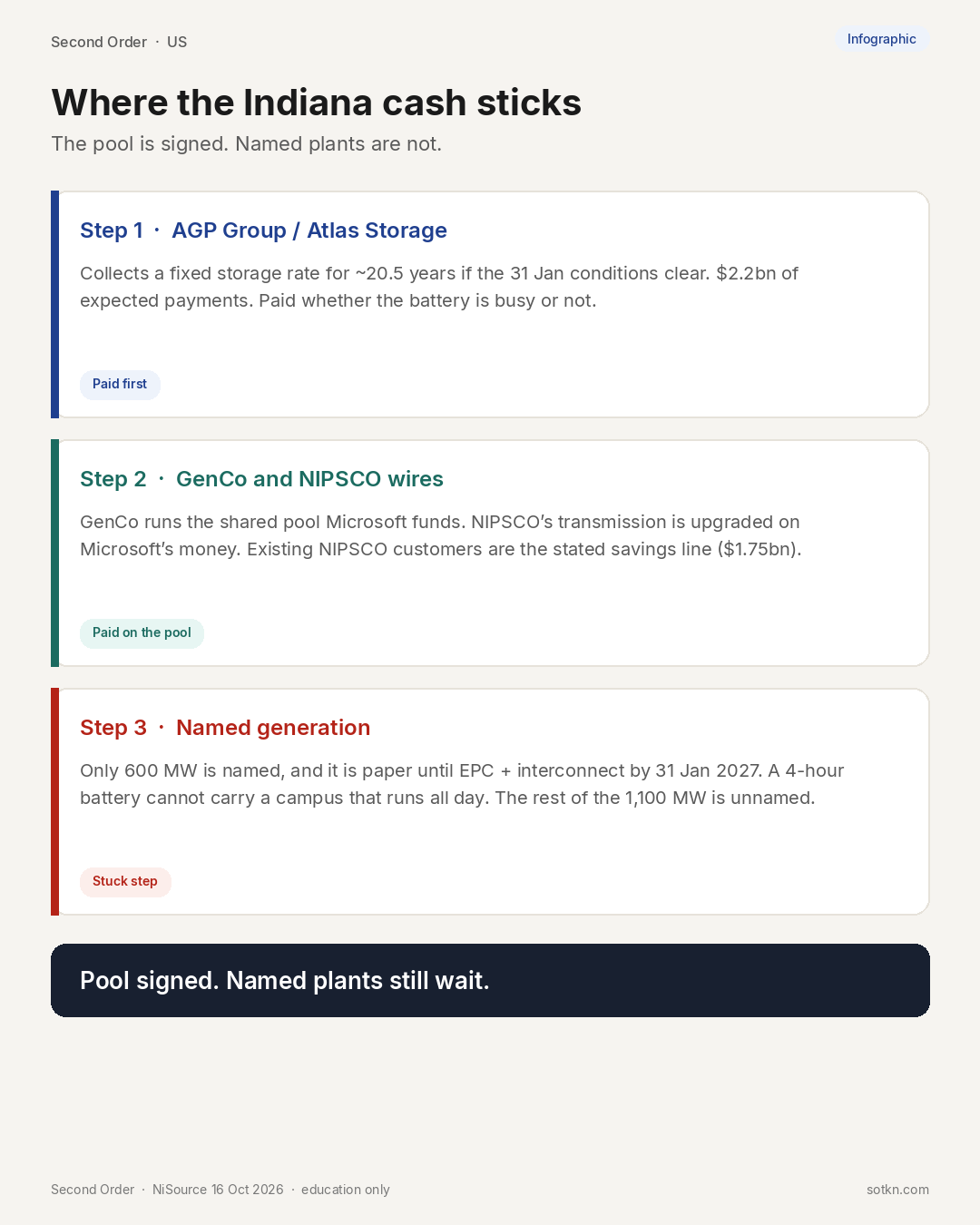

Where does the money stick?
At the step that already has a toll, and not at the step that is still an empty pad.

1. AGP Group, on the storage payments. Atlas Storage 1 LLC collects a fixed storage rate for two decades if 31 January clears. The 8-K is explicit: payments are based on a fixed rate and actual power capacity. That is who gets paid first on the only named plant. Cell, inverter and transformer suppliers sit behind AGP; they are not named.
2. GenCo, on the pool. Microsoft funds generation and transmission. GenCo runs the portfolio NIPSCO dispatches for large-load customers together. The 16 October release is the pool story: Microsoft joins a shared machine rather than getting Schahfer-style dedicated turbines. GenCo also signs the toll, pays to charge the battery, and keeps MISO revenue. If the pool runs short, that gap is GenCo’s before it is Microsoft’s hall.
3. NIPSCO’s wires, on Microsoft’s money. The release says the new assets will upgrade NIPSCO’s transmission system. Existing electric customers are the stated $1.75 billion savings line, including as much as $140 a year. That is a claim over the life of the contracts, not a tariff sheet.
4. Named generation for Microsoft — not yet. Amazon’s IURC Cause 46362 order named sites: two 1,300 MW combined-cycle plants at Schahfer and a 400 MW battery at Mitchell, with testimony of up to 3,000 MW to cover 2,400 MW of load. Microsoft’s papers name a pool add and one battery that is not yet binding. One-line rule: while this shape holds, the toll is the cash, the pool is the contract, and extra named megawatts still wait.

Is named generation still stuck?
Yes. A 20-year agreement and a 1,100 MW pool add are a customer contract. They are not a turbine, a busbar, or an interconnection that exists.
Three things keep it stuck. First, the conditions. The only named plant does not exist until AGP signs an EPC contract and a MISO interconnection agreement by 31 January 2027. Miss that date and the $2.2 billion toll is not effective. That is 104 days from this desk (our arithmetic).
Second, the duration. Four hours of storage cannot carry a training hall that wants power all day. Even if the 600 MW counts toward the 1,100 MW, the unnamed remainder has to do the night shift, and NiSource has not named it.
Third, the clocks in front of a hall. Service starts in 2028. The release lists regulatory approval as a risk. NERC’s 50 MW standards now sit in front of every US AI hall of this size: board, then FERC. NERC’s January assessment already had summer peak demand up more than 224 GW over ten years, mostly data centres. None of those clocks expires because a pool was signed.
The 15 October US pulse already had the stuck step as firm power at the hall. This print does not move it. It adds a customer to the same bind, on an Indiana pool instead of a Wyoming yard.

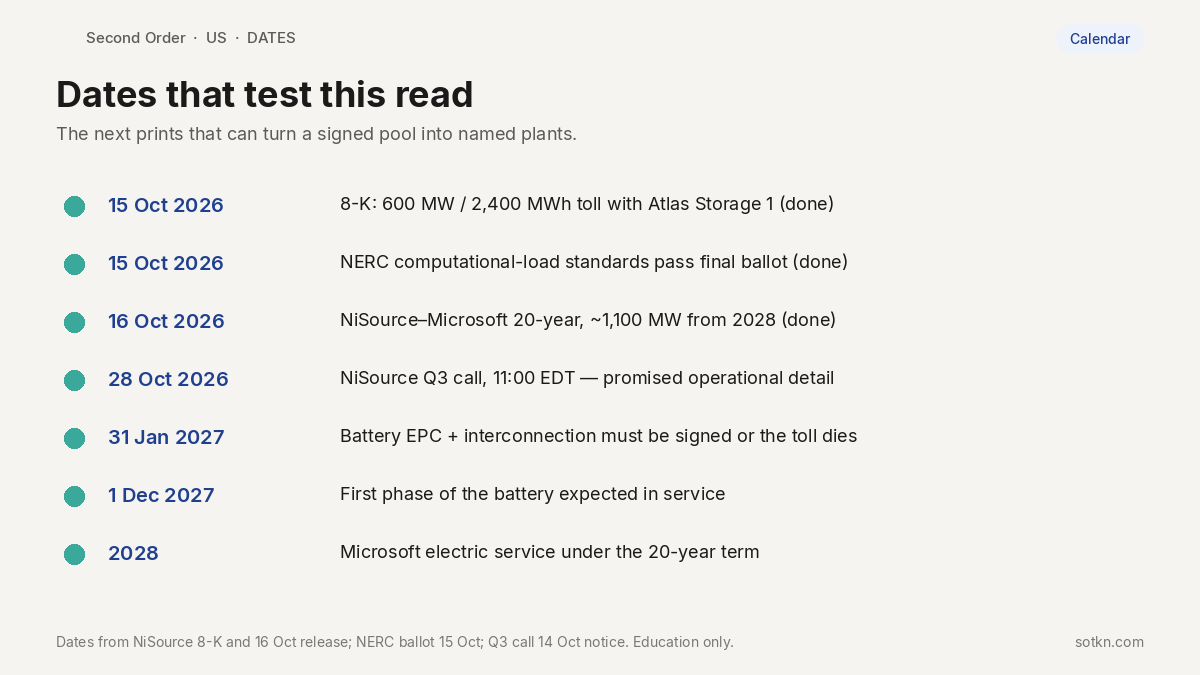

What dates matter

- 15 October 2026 — Form 8-K event date. 600 MW / 2,400 MWh toll with Atlas Storage 1 LLC (done).
- 15 October 2026 — NERC Project 2026-02 final ballot (done). 50 MW computational loads at 100 kV.
- 16 October 2026 — NiSource–Microsoft release. About 1,100 MW, 20 years from 2028 (done).
- 28 October 2026, 11:00 EDT — NiSource Q3 call. The test: does a plant list, a Microsoft load figure, or a capex number appear, or only the pool language again?
- 31 January 2027 — Battery EPC and interconnection. The test: does the only named plant become a real contract, or does the toll die?
- 1 December 2027 — First phase of the battery expected in service. The test: is anything actually discharging on MISO, or has the date slipped?
- 2028 — Microsoft electric service under the 20-year term. The test: are the unnamed megawatts named before the hall wants them?
The 28 October call can colour the dollars. Only a plant list, an IURC special-contract filing, or the 31 January papers can move the stuck step.
How is this different from the 15 October fuel-cell Pulse?
The 15 October pulse was AEP’s $4 billion, 702 MW fuel-cell plant for Google in Wyoming, cells ordered before Google was named. Who got paid was the gear maker. The stuck step was firm power at the hall.
Today is a Microsoft cheque into an Indiana pool, plus an 8-K for a 600 MW battery that is not yet binding. Who gets paid is AGP on the toll and GenCo on the pool. The stuck step is still named generation — the same family as firm power at the hall, a different receipt. Google’s Wyoming plant is a named yard. Microsoft’s 1,100 MW is not.
It is also different from PJM’s 6.8 GW short (a capacity auction, not a customer contract), from Texas’s $50,000-per-MW large-load rule (a queue price, with switch-on paused), and from Census’s $85 billion data-hall build (buildings, not watts). Same US door — power-ready halls — different paper.
What would change this view?
- NiSource, on 28 October, names the plants behind the 1,100 MW and states whether the 600 MW battery is inside that number.
- A NIPSCO filing at the Indiana regulator with the Microsoft special contract and a site list, the way Amazon’s 2,400 MW was listed in Cause 46362.
- AGP Group signing its EPC contract and a satisfactory interconnection agreement before 31 January 2027, which makes the only named plant real.
- A FERC filing covering NIPSCO and GenCo serving Microsoft.
- A Microsoft load figure, in megawatts, rather than a pool-add figure.
- Evidence that four-hour storage plus unnamed market purchases can carry the campus without new thermal plants — which would move the bind, not remove it.
The view stays intact while the 1,100 MW remains a pool add, the only named plant remains a conditional toll, and 2028 remains the first year Microsoft takes service.
Practical takeaways
- NiSource, 16 Oct: Microsoft, 20 years from 2028, about 1,100 MW into a shared GenCo pool. Microsoft funds generation and transmission
- 8-K, 16 Oct: 600 MW / 2,400 MWh battery, $2.2bn expected payments, ~20.5 years, first phase by 1 Dec 2027. Not effective until EPC + interconnect by 31 Jan 2027
- Who gets paid: AGP Group on the toll; GenCo on the pool; NIPSCO wires on Microsoft’s money
- Our arithmetic: 4.0-hour battery; $14.90 per kW-month; 54.5% named if the battery counts; ~880 MW of load at Amazon’s 1.25 ratio — illustration only
- NERC, 15 Oct: 50 MW computational-load standards passed final ballot. 1,100 MW is 22× that floor (our arithmetic)
- Stuck step: named generation. A signed pool is not a plant. Service is 2028
- Watch 28 Oct (Q3 call), 31 Jan 2027 (battery conditions)
FAQ
What did NiSource announce on 16 October 2026?
A 20-year energy agreement with Microsoft for the northwest Indiana data-centre campus. About 1,100 MW is added to the GenCo pool, Microsoft funds the generation and transmission it needs, and service is expected to start in 2028. Expected savings for existing NIPSCO electric customers rise to about $1.75 billion. The release is dated 16 October 2026.
Who gets paid on this print?
AGP Group, on expected $2.2 billion of battery storage payments if 31 January 2027 clears, per the 8-K. GenCo, which runs the shared pool. NIPSCO, whose transmission is upgraded on Microsoft’s money. This is a map of who gets paid, not a buy list.
Why are named plants still the stuck step if 1,100 MW was signed?
Because a pool add is not a plant list. The only named resource is a 600 MW four-hour battery whose toll is conditioned on an EPC contract and an interconnection agreement by 31 January 2027. NiSource has not said the battery is inside the 1,100 MW. Service starts in 2028.
Does the 600 MW battery equal the 1,100 MW?
No. 600 is 54.5% of 1,100 (our arithmetic) only if NiSource counts it that way, which it has not. A four-hour battery cannot carry a 24-hour campus on its own. The unnamed remainder has to be something else.
Is this investment advice?
No. Education only. It maps who gets paid and which step is stuck. It is not a recommendation to buy or sell any security.
