Princeton Digital seeks $1.2B for 198.8 MW Johor data center

Princeton Digital Group is seeking up to US$1.2 billion for a 198.8 MW Johor data center campus. A day later Malaysia said operators will pay for power they book but do not use. The banks are lending; the tenant is not named.

Share
$1.2B for Johor, every booked MW billed. A power transmission tower on a ridge at dusk, graded navy, with an amber glow behind the tower.
Base photo: transmission tower at dusk, 31 Dec 2016, by Adi Ulici via Wikimedia Commons (CC0), graded for Second Order. Not a Johor or Princeton Digital site.

WIRE · AI DATA CENTERS · MALAYSIA · Data as at 19 Oct 2026

Princeton Digital Group is seeking a syndicated loan of up to US$1.2 billion to fund a 198.8 MW data center campus in Johor and to refinance existing debt, Bloomberg reported on 14 October 2026. Five banks are arranging the three-year deal. The next day, Malaysia's trade minister told Parliament that data centres will pay for power they book but do not use. Put the two together and the money is easy to find. What is hard to find is the tenant. On the AI data centers layer, the loan is the easy part. Filling every booked megawatt is the stuck step.

What happened

14 October 2026 · Bloomberg, via The Edge and The Star

Up to US$1.2 billion (about RM4.9 billion), three years, for a 198.8 MW Johor campus and a refinancing

The borrower is Princeton Digital Group Labuan Alpha. The source is a person familiar with the deal; the company did not comment

The banks

HSBC, Maybank Investment Bank, OCBC Malaysia, Standard Chartered and UOB lead the loan

Princeton Digital is based in Singapore. Warburg Pincus is its top shareholder, alongside Stonepeak, Mubadala and Ontario Teachers'

The borrowing run

A US$5 billion debt target for 2026, about US$856 million already raised for Indonesia

The company runs more than 1.8 GW across seven Asian markets. In Johor it already has JH1 at Sedenak Tech Park, whose 52 MW first phase was delivered in July 2024

15 October 2026 · Dewan Rakyat

Book 200 MW, use 100, and you pay for the other 100

Minister Johari Abdul Ghani also said investors must pay for the grid upgrades their projects need, with no subsidy, and that operators who do not pay cannot operate


Why cash cares

A data center loan is a bet on a lease. The bank lends against halls that a tenant will rent, and the rent pays the interest. Before this month, who paid for an idle power booking in Malaysia was not set out in public. After the minister's answer on 15 October, an empty hall costs its owner the rent it is not collecting and a power bill for capacity booked and not used. The rate and the start date of that charge have not been published. The direction is clear: the cost of an unfilled booking moves from Tenaga Nasional, the national grid company, onto the hall's owner. We traced that rule in Booked, not used.

That makes the tenant line the most important line in Princeton Digital's loan, and it is the one the reports leave out. Bloomberg's source did not name a customer for the 198.8 MW campus, or say whether it is an expansion of JH1 or a new site.

The loan is also short. Three years is construction money. Our read is that it gets refinanced once the halls are leased and switched on. JH1, the company's first Johor campus, was funded with its own RM1.276 billion green loan in 2024. If the halls fill on time, the refinancing is routine. If they fill slowly, the owner pays for the empty part twice: once in lost rent, and again in the power bill for megawatts it booked.

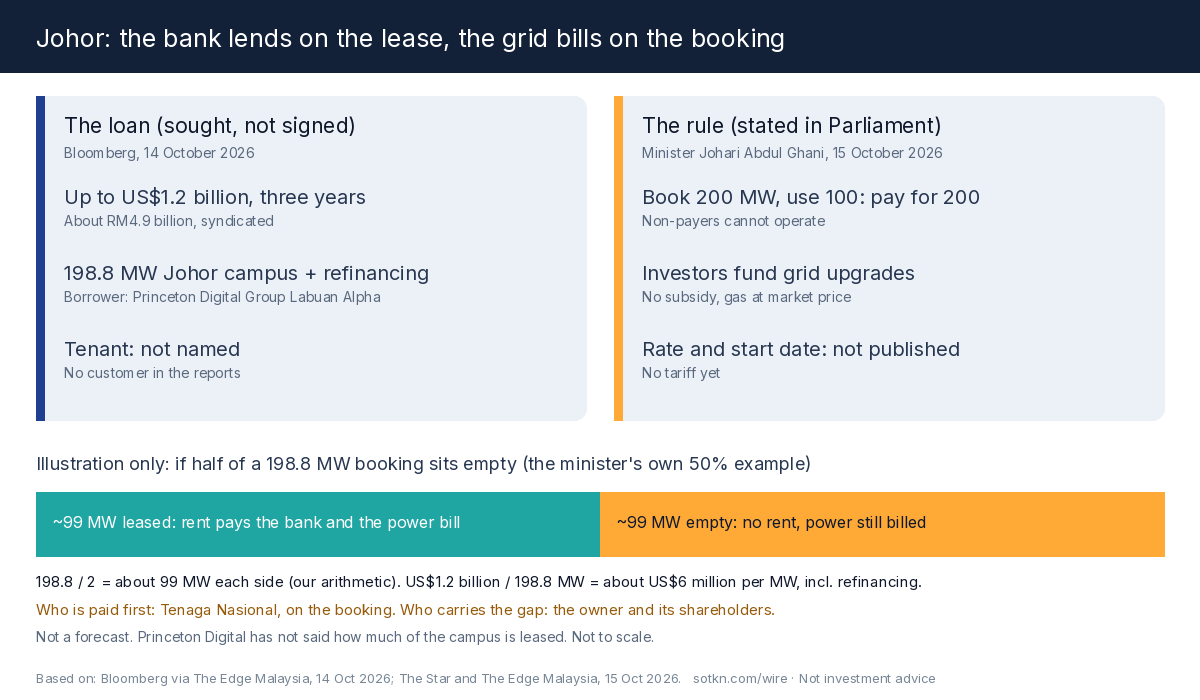

Princeton Digital's US$1.2 billion Johor loan beside Malaysia's new rule on booked but unused power: who is paid on the booking, who pays when a hall sits empty

Figure: The bank lends on the lease. The grid bills on the booking. What was reported on 14 and 15 October 2026.

The second-order read

Who gets paid. Tenaga Nasional first: under the minister's rule it is paid on the booking whether the hall is full or not. Then the five arranging banks, through fees and interest the reports do not disclose, and the existing lenders whose debt the loan refinances. Then the builders and equipment suppliers on the Johor site, where Malaysia's data centre task force has set a minimum of 30% local content.

Who carries the risk. Princeton Digital and its shareholders. If part of the campus is booked but not leased, they pay for that power and still owe the banks. At up to US$1.2 billion for 198.8 MW, the loan works out to about US$6 million per megawatt (our arithmetic). Some of that is refinancing, so new money per megawatt is lower.

Who waits. Equity. Two of the region's floats have just stalled. Firmus pulled its Australian listing and AirTrunk put its Singapore REIT on hold until 2027. Banks are still lending. Builders who planned to recycle cash through a listing have to wait.

Stuck step. A signed tenant for every booked megawatt. The loan, the grid and the power are all on offer in Johor. The bill for empty capacity now lands on whoever booked it.

Two cautions

This is a loan being sought, reported by one news agency from one unnamed source. The final size, price and tenor can change, and the company has not confirmed it.

The rule on unused power is a minister's answer in Parliament, not a published tariff. Until the rate, the start date and any grace period for a phased build are set, nobody can put a number on what an empty megawatt costs in Johor.

What would change the view

  • Princeton Digital naming an anchor tenant for the 198.8 MW campus, or a hyperscaler lease filed by a listed customer.
  • Malaysia publishing a charge that lets phased campuses book power in steps, which would shrink the cost of a slow lease-up.
  • The loan signing larger or longer than reported, which would show banks are comfortable with the tenant risk.

What to watch

  • The signing of the loan, and whether its final size or tenor moves from the US$1.2 billion and three years reported.
  • The Energy Commission or TNB publishing the unused-capacity charge, with a rate and a start date.
  • More Johor campus loans from other operators, now that lenders have to price a booked megawatt that might sit empty.

Read: the AI data centers layer, 18 sen to use the wire, and Booked, not used


Get the Wire. A free brief every day, here and in your inbox. Subscribe free →

Not investment advice. Do your own research. The US$6 million per megawatt figure is our arithmetic from the reported loan size and campus capacity, and includes the refinancing share.

References

  1. The Edge Malaysia (Bloomberg), "Singapore's Princeton Digital Group seeks US$1.2 bil loan for Malaysia data centre", 14 Oct 2026. Loan size, tenor, banks, borrower, the 198.8 MW campus, shareholders, the Indonesia raise and the US$5 billion debt target.
  2. The Straits Times (Bloomberg), "Singapore's PDG seeks US$1.2 billion loan for Malaysia data centre", 14 Oct 2026. The same report, with AirTrunk's REIT listing pushed to 2027.
  3. EdgeProp.my, "Princeton Digital seeks up to RM4.9b loan for Johor data centre campus", 14 Oct 2026. JH1 at Sedenak, its 52 MW first phase and its RM1.276 billion green loan.
  4. The Star, "Data centres must pay for unused power allocations, says Johari", 15 Oct 2026. The 200 MW booked, 100 MW used example and the rule that non-payers cannot operate.
  5. The Edge Malaysia, "Data centre investors must bear necessary grid upgrade costs, says Johari Ghani", 15 Oct 2026. Grid upgrade costs on investors, no subsidy, gas at market price and the 30% local content minimum.
